Charter El Paso Airport Remodel
7010 Airport Road, El Paso, TX, 79906
Charter El Paso Airport Remodel is a renovation/alteration project at 7010 Airport Road, El Paso, in El Paso County, TX, tracked from its Texas Department of Licensing and Regulation (TDLR) registration. Under construction, estimated completion Dec 2026. The project has an estimated value of $1.2M across about 39,318 sq ft.
- Estimated project value
- $1.2M
About this figure
Estimated construction cost supplied in the TDLR filing. This is not a current property appraisal or a final construction invoice.
- Reported floor area
- 39,318 ft²
About this figure
Square footage reported for this scope of work. It may cover only part of a larger property.
- Estimated cost / ft²
- $31/sqft
About this figure
Calculated from this filing’s estimated cost divided by its reported square footage. Available only when both figures are supplied; it is not a market benchmark.
- Scheduled duration
- 9 months
About this figure
The interval between the filed start and completion dates. These dates describe the proposed schedule and do not measure actual construction progress.
The project record
Project timeline
Explore filed milestones and scheduled dates. Open a milestone for its source.
4 timeline dates shown.
Project registered · TDLR filing
Registration of the project with the Texas Department of Licensing and Regulation.
Source: TDLR filing
View source recordReview complete · TDLR filing
The filing records completion of the accessibility review.
21 days after the preceding date shown.
Source: TDLR filing
View source recordScheduled construction start · Scheduled date
A date supplied in the filing; this does not confirm that work started or finished.
56 days after the preceding date shown.
Source: TDLR filing
View source recordScheduled completion · Scheduled date
A date supplied in the filing; this does not confirm that work started or finished.
258 days after the preceding date shown.
Source: TDLR filing
View source record
📰About Charter El Paso Airport Remodel
Time Warner Cable Texas, LLC is renovating a 39,318 sq ft interior space at 7010 Airport Road in El Paso. The project, filed under the name Charter El Paso Airport Remodel, involves an alteration of an existing call center. The work is scheduled to finish in December 2026, with construction beginning in March 2026.
The estimated cost for this renovation is $1,200,000. This figure places the project in the top quarter of estimated costs among 3875 TDLR-registered renovation and alteration filings in El Paso County. The median estimated cost for similar projects in the county is $204,000, while the middle half of filings range from $100,000 to $511,500.
Design and Construction Details
Link Architecture serves as the design firm of record. The firm has six other TDLR-registered projects totaling $3,554,500, including locations in Austin, Round Rock, Celina, and Princeton. The registered accessibility specialist for this project is Julie Ericson Gereda. The project is privately funded on private land for private use.
The cost per square foot is $31, which is below the county median of $66 per square foot for renovation and alteration projects. The scheduled build window is 258 days, longer than the county median of 120 days. TDLR completed plan review in January 2026, and the status is Review Complete.
Local Context
The project is located in ZIP code 79906, which has a population of about 6,061 and a median household income of $51,907 according to U.S. Census ACS 2023 five-year estimates. There are 1,688 housing units in this area. El Paso County unemployment was 4.8 percent in July 2026, higher than a year earlier.
Review Complete
Design review complete, construction may proceed
Follow this project
Get an email when the status changes — permits pulled, construction started, work finished. Free, and nothing else.
Or watch all projects in 79906 (El Paso)
One email per change. Unsubscribe in one click. Privacy.
Charter El Paso Airport Remodel is a Renovation/Alteration project located at 7010 Airport Road, El Paso, TX 79906 in El Paso, Texas. The project has an estimated value of $1.2M covering 39,318 sq ft. Time Warner Cable Texas, LLC is the property owner and Link Architecture is the design firm of record. The project was registered with TDLR on December 31, 2025.
Frequently Asked Questions
What is the scope of the Charter El Paso Airport Remodel?
The scope is an interior remodel of an existing call center. The project is a renovation or alteration type of work.
Who is the owner of record for this project?
Time Warner Cable Texas, LLC is the owner or developer of record for the project at 7010 Airport Road.
When is construction scheduled to start and finish?
Construction is scheduled to start in March 2026 and is scheduled to finish in December 2026.
Is the business open?
The TDLR record covers construction status only. The project is under renovation and scheduled to finish in December 2026.
What is Charter El Paso Airport Remodel?
Charter El Paso Airport Remodel is a renovation/alteration project at 7010 Airport Road in El Paso, Texas, registered with the Texas Department of Licensing and Regulation (TDLR). Scope of work: Interior remodel of existing call center
Is Charter El Paso Airport Remodel open in El Paso?
Charter El Paso Airport Remodel is still under construction in El Paso, TX, with an estimated completion of Dec 2026 according to its TDLR registration.
Where is Charter El Paso Airport Remodel located?
Charter El Paso Airport Remodel is located at 7010 Airport Road, El Paso, TX, 79906, in El Paso County.
Who is the owner or developer of Charter El Paso Airport Remodel?
Time Warner Cable Texas, LLC is the property owner/developer of record for Charter El Paso Airport Remodel, per its TDLR project registration.
Who is the architect or design firm for Charter El Paso Airport Remodel?
Link Architecture is the design firm of record for Charter El Paso Airport Remodel, according to its TDLR filing.
How much does Charter El Paso Airport Remodel cost and how big is it?
Charter El Paso Airport Remodel has an estimated construction value of $1.2M and approximately 39,318 square feet (about $31/sqft), based on its TDLR filing.
Scope of Work
Interior remodel of existing call center
Note: This project is registered under the Texas Accessibility Standards (TAS) program. TDLR registration is required for commercial and public facility construction to ensure compliance with accessibility requirements under Texas Government Code Chapter 469.

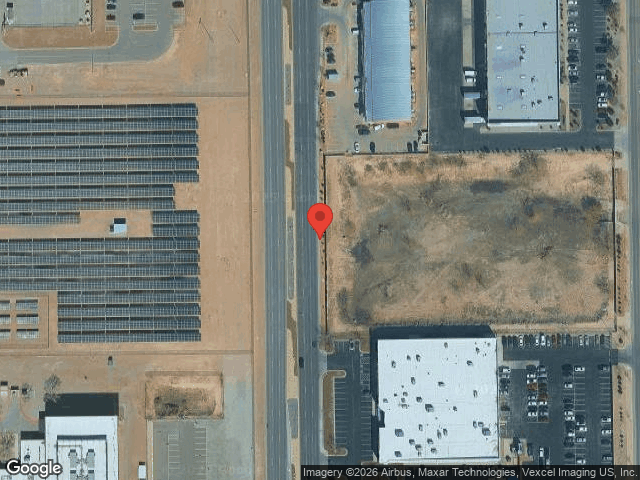

Location & views
7010 Airport Road, El Paso, TX, 79906
Related Projects
Watch all construction in 79906 (El Paso)
A short email when anything new is filed in this ZIP. One ZIP free, weekly.
Unsubscribe in one click. Privacy.
Keep exploring
What else is changing in El Paso?
See the surrounding filings, compare the reported schedules, and follow the places that matter to you.
