600 Building Renovation & Middle School Restroom Addition (1) in Nixon, TX
800 N Rancho Rd, Nixon, TX, 78140
600 Building Renovation & Middle School Restroom Addition (1) is a renovation/alteration project at 800 N Rancho Rd, Nixon, in Gonzales County, TX, tracked from its Texas Department of Licensing and Regulation (TDLR) registration. Construction complete (TDLR inspection passed Oct 2026). The project has an estimated value of $1.4M across about 9,544 sq ft.
- Estimated project value
- $1.4M
About this figure
Estimated construction cost supplied in the TDLR filing. This is not a current property appraisal or a final construction invoice.
- Reported floor area
- 9,544 ft²
About this figure
Square footage reported for this scope of work. It may cover only part of a larger property.
- Estimated cost / ft²
- $147/sqft
About this figure
Calculated from this filing’s estimated cost divided by its reported square footage. Available only when both figures are supplied; it is not a market benchmark.
- Scheduled duration
- 8 months
About this figure
The interval between the filed start and completion dates. These dates describe the proposed schedule and do not measure actual construction progress.
The project record
Project timeline
Explore filed milestones and scheduled dates. Open a milestone for its source.
6 timeline dates shown.
Project registered · TDLR filing
Registration of the project with the Texas Department of Licensing and Regulation.
Source: TDLR filing
View source recordReview complete · TDLR filing
The filing records completion of the accessibility review.
Same day as the preceding date shown.
Source: TDLR filing
View source recordScheduled construction start · Scheduled date
A date supplied in the filing; this does not confirm that work started or finished.
90 days after the preceding date shown.
Source: TDLR filing
View source recordScheduled completion · Scheduled date
A date supplied in the filing; this does not confirm that work started or finished.
245 days after the preceding date shown.
Source: TDLR filing
View source recordInspection complete · TDLR filing
The filing records completion of the accessibility inspection.
110 days after the preceding date shown.
Source: TDLR filing
View source recordProject closed · TDLR filing
The project record was closed in TDLR.
146 days after the preceding date shown.
Source: TDLR filing
View source record
📰About 600 Building Renovation & Middle School Restroom Addition (1)
Nixon-Smiley Consolidated ISD completed a $1,400,000 renovation at 800 N Rancho Rd in Nixon, Texas, in 2026. The project, filed as the 600 Building Renovation & Middle School Restroom Addition, covered 9,544 sq ft of interior finish and ADA restroom upgrades. TDLR closed the project file in October 2026, confirming the end of the accessibility review process for this construction.
The district engaged LaMarr Womack & Associates LP as the design firm of record for this alteration. Steve R Zoerner served as the registered accessibility specialist. The work focused on improving interior finishes and ensuring restroom accessibility within the existing school structure. The project was registered with TDLR in March 2025, with plan review completing in the same month.
Construction began in June 2025 according to the filing. The scheduled build window was 245 days, matching the median scheduled build window for renovation and alteration projects in Gonzales County. The estimated cost of $1,400,000 places the project above the county median of $850,000 for similar work. However, the cost per square foot of $147 is close to the county median of $142, reflecting standard pricing for this type of scope.
Nixon-Smiley CISD is not a one-time filer in Gonzales County. The district has five other TDLR-registered projects totaling $17,282,000 in the area. These include high school renovations, a middle school project, and agricultural facility updates. LaMarr Womack & Associates LP has also designed six other projects across Texas, totaling $6,368,113, indicating a consistent partnership with public education clients for accessibility-compliant renovations.
The final inspection passed in May 2026, preceding the official closure of the TDLR file. This timeline confirms that the physical construction and accessibility compliance checks were completed before the administrative process concluded. The project stands as a finished renovation of a key school facility in Nixon, serving the local student population in Gonzales County.
Project Closed
Project has been completed and closed
Follow this project
Get an email when the status changes — permits pulled, construction started, work finished. Free, and nothing else.
Or watch all projects in 78140 (Nixon)
One email per change. Unsubscribe in one click. Privacy.
600 Building Renovation & Middle School Restroom Addition (1) is a Renovation/Alteration project located at 800 N Rancho Rd, Nixon, TX 78140 in Nixon, Texas. The project has an estimated value of $1.4M covering 9,544 sq ft. Nixon-Smiley Consolidated ISD is the property owner and LaMarr Womack & Associates LP is the design firm of record. The project was registered with TDLR on March 3, 2025.
Frequently Asked Questions
Is the renovation at 800 N Rancho Rd finished?
Yes. The final inspection passed in May 2026, and TDLR closed the project file in October 2026. This confirms the construction and accessibility review process is complete.
Who designed the Nixon High School renovation?
LaMarr Womack & Associates LP is the design firm of record. Steve R Zoerner was the registered accessibility specialist for the project.
What was the cost per square foot for this project?
The estimated cost was $1,400,000 for 9,544 sq ft, resulting in a cost of $147 per sq ft. This is close to the Gonzales County median of $142.
What specific work was done on the building?
The scope included interior finish and ADA restrooms. The project is classified as a Renovation/Alteration of the existing 600 Building and Middle School Restroom Addition.
Does Nixon-Smiley CISD have other recent projects?
Yes. The district has five other TDLR-registered projects in Gonzales County totaling $17,282,000. These include high school renovations and agricultural facilities.
What is 600 Building Renovation & Middle School Restroom Addition (1)?
600 Building Renovation & Middle School Restroom Addition (1) is a renovation/alteration project at 800 N Rancho Rd in Nixon, Texas, registered with the Texas Department of Licensing and Regulation (TDLR). Scope of work: Interior finish & ADA restrooms.
Is 600 Building Renovation & Middle School Restroom Addition (1) open in Nixon?
Construction on 600 Building Renovation & Middle School Restroom Addition (1) is complete — TDLR records show the project passed its required accessibility inspection in Oct 2026. The building is finished and very likely open.
Where is 600 Building Renovation & Middle School Restroom Addition (1) located?
600 Building Renovation & Middle School Restroom Addition (1) is located at 800 N Rancho Rd, Nixon, TX, 78140, in Gonzales County.
Who is the owner or developer of 600 Building Renovation & Middle School Restroom Addition (1)?
Nixon-Smiley Consolidated ISD is the property owner/developer of record for 600 Building Renovation & Middle School Restroom Addition (1), per its TDLR project registration.
Who is the architect or design firm for 600 Building Renovation & Middle School Restroom Addition (1)?
LaMarr Womack & Associates LP is the design firm of record for 600 Building Renovation & Middle School Restroom Addition (1), according to its TDLR filing.
How much does 600 Building Renovation & Middle School Restroom Addition (1) cost and how big is it?
600 Building Renovation & Middle School Restroom Addition (1) has an estimated construction value of $1.4M and approximately 9,544 square feet (about $147/sqft), based on its TDLR filing.
Scope of Work
Interior finish & ADA restrooms.
Note: This project is registered under the Texas Accessibility Standards (TAS) program. TDLR registration is required for commercial and public facility construction to ensure compliance with accessibility requirements under Texas Government Code Chapter 469.
Location & views

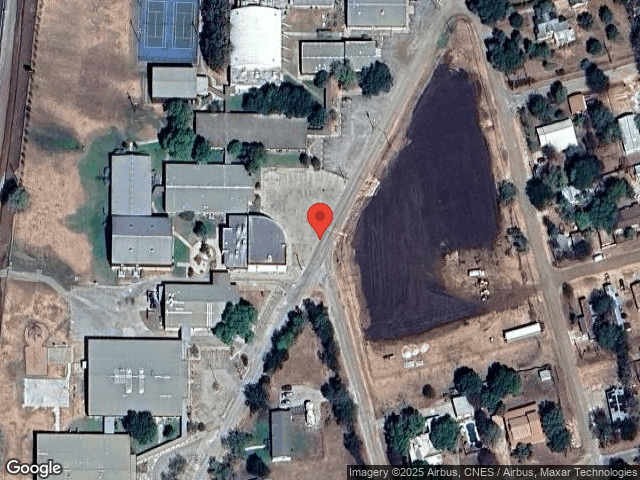

800 N Rancho Rd, Nixon, TX, 78140
Explore the supplied address
A precise map point has not been loaded. Choose to look up the address, or open it in Google Maps using the link below.
Related Projects
Same Owner
$23.3M totalWatch all construction in 78140 (Nixon)
A short email when anything new is filed in this ZIP. One ZIP free, weekly.
Unsubscribe in one click. Privacy.
Keep exploring
What else is changing in Nixon?
See the surrounding filings, compare the reported schedules, and follow the places that matter to you.
